CONSTRUCTION

The 11th & Lewis Avenue Streetscape Project will build public realm improvements that create a renewed sense of place and redevelopment for a new destination district on the Mother Road.

The project’s goals are to ensure safety, provide comfort, and promote identity. This will be accomplished with wider sidewalks, increased street lights, added amenities (like bike racks, benches, etc.), trees, landscaping, and more.


neon 176.jpg

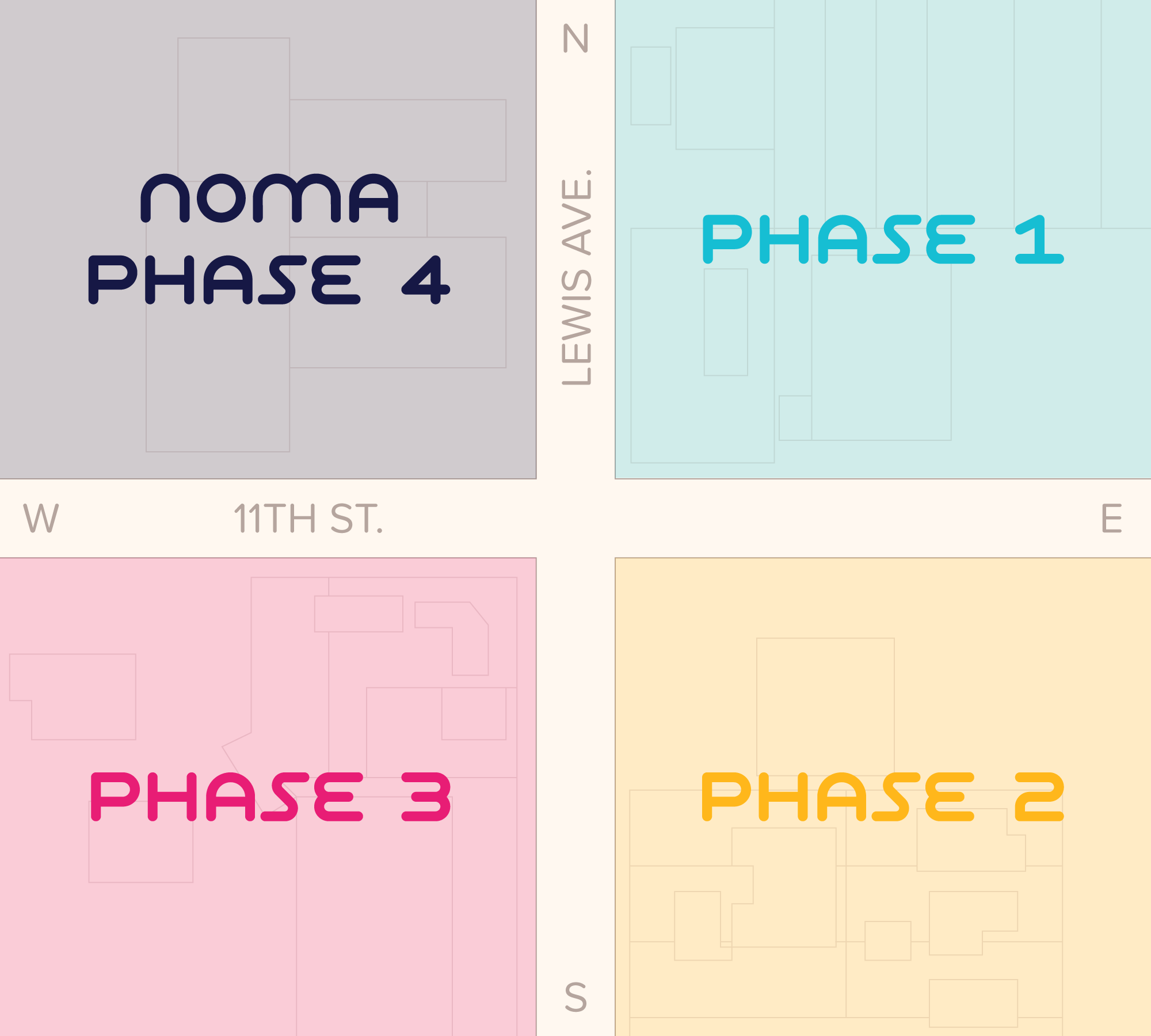

Construction Phases



The construction will happen in four phases in order to decrease the impact on businesses and residents. An overview of the 11th & Lewis Avenue Streetscape Project Plan is outlined below.



PHASE 1

NE Corner of 11th & Lewis

(Hawk Dairy Building Area)

September 7, 2021- December 30, 2021

PHASE 2

SE Corner of 11th & Lewis

(Advance Auto Parts Area)

January 4, 2022- March 11, 2022

PHASE 3

SW Corner of 11th & Lewis

(Shops at Mother Road Market Area)

March 12, 2022- May 18, 2022

PHASE 4

NW Corner of 11th & Lewis

(Former Welding School Lot Area)

May 19, 2022- September 6, 2022



Planned Project Completion Date: 9/6/22

This is a projected schedule only. Dates and phases are subject to change based on weather, holidays or other circumstances outside our control.

We will update the site to keep the information as accurate as possible. If you have questions or feedback, please email: shelley@mettise.com.

Project Team & Contacts



Shelly Cadamy

Project Consultant

Mettise Group

Elizabeth Frame Ellison

CEO & President

Lobeck Taylor Family Foundation

Samantha Extance

LTFF Project Manager

Lobeck Taylor Family Foundation



Chris Hermann

AICP - Principal

MKSK

Brian Paschal

Managing Director

Lobeck Taylor Family Foundation

Scott Rodehaver

PE- Principal

Wallace Engineering



Brooke Caviness

PE- Project Engineer / Senior Engineer

City of Tulsa

Tim Rosenthal

PLA - Project Manager & Landscape Architect

MKSK



Construction Timeline:

  • Phase One (Northeast) - September 7, 2021- December 30, 2021

  • Phase Two (Southeast) - January 4, 2022- March 11, 2022

  • Phase Three (Southwest) - March 12, 2022- May 18, 2022

  • Phase Four (Northwest) - May 19, 2022- September 6, 2022

Completed:

  • Groundbreaking Press Conference - July 14, 2021

  • Groundbreaking - Mid-Late July 2021 Contractor Bidding Process - Completed June 2021

  • Construction Plan Approval by City of Tulsa - Completed March 2021

  • 11th & Lewis TIF Project Plan Presentation to Tulsa Route 66 Commission - Completed February 2020

  • Tulsa Industrial Authority enters into financing assistance agreement with LTFF for 11th & Lewis Corridor Project Plan - Completed March 2019

  • Ordinance No. 24046 (mentioned above) is signed by Mayor G.T. Bynum - December 2018

  • Ordinance No. 24046, approving and adopting the 11th & Lewis Corridor Project Plan and establishing two new increment districts, is adopted by Tulsa City Council - Completed November 2018

  • Tulsa City Council Public Hearings held - Completed November 2018

  • Financial Impacts Report for 11th & Lewis Corridor Project Plan Published - Completed November 2018

  • Eligibility Report for 11th & Lewis Corridor Project Plan Published - Completed November 2018

  • Tulsa Metropolitan Area Planning Commission approves the 11th & Lewis Corridor Project Plan - Completed November 2018

  • City of Tulsa Review Committee reviews & recommends 11th & Lewis Corridor Project Plan - Completed October 2018

  • TIF Application for 11th & Lewis Corridor Project Plan Submitted - Completed August 2017
